The Vermont Agency of Transportation in conjunction with A.L. St. Onge Contractor Inc. (St. Onge) will be replacing Bridge #24 on VT Route 118 in Enosburgh approximately 3 miles from the intersection of VT Route 118 & VT Route 105.
St. Onge has begin the installation of a temporary bridge structure and will continue with building the approaches to the temporary structure for the week beginning April 19, 2021. Motorist should expect a lane closure with traffic control until the anticipated date of April 29, 2021, when traffic will then be detoured over the temporary bridge. The anticipated completion is October 2021.
Traffic is now directed onto the temporary bridge however, motorists should be aware of construction vehicles entering/exiting the work zone.
Construction Updates
The following is the anticipated work schedule for the week beginning Monday, August 23, 2021:
- Continued removal of the temporary detour
The following is the anticipated work schedule for the week beginning Monday, August 16, 2021:
- Continued removal of the temporary detour
The following is the anticipated work schedule for the week beginning Monday, August 9, 2021:
- Continued removal of the temporary detour
- Continued project cleanup
- Motorists should be aware of truck traffic entering/exiting the work zone.
The following is the anticipated work schedule for the week beginning Monday, August 2, 2021:
- Removal of temporary detour
- General cleanup work throughout the project
The following is the anticipated work schedule for the week beginning Monday, July 26, 2021:
- Weather permitting, line striping
- General cleanup work throughout the project
The following is the anticipated work schedule for the week beginning Monday, July 19, 2021:
- Installation of guardrail.
The following is the anticipated work schedule for the week beginning Monday, July 12, 2021:
- Complete fine grading the subbase and other related work to prepare for paving.
The following is the anticipated work schedule for the week beginning Monday, July 5, 2021:
- No work due to the Independence Day holiday
- Cleanup work in preparation for paving
The following is the anticipated work schedule for the week beginning Monday, June 28, 2021:
- Concrete continues to cure
- Paving of the bridge approaches
The following is the anticipated work schedule for the week beginning Monday, June 21, 2021:
- Concrete poured for the bridge deck; Minimal work to allow for curing time.
The following is the anticipated work schedule for the week beginning Monday, June 14, 2021:

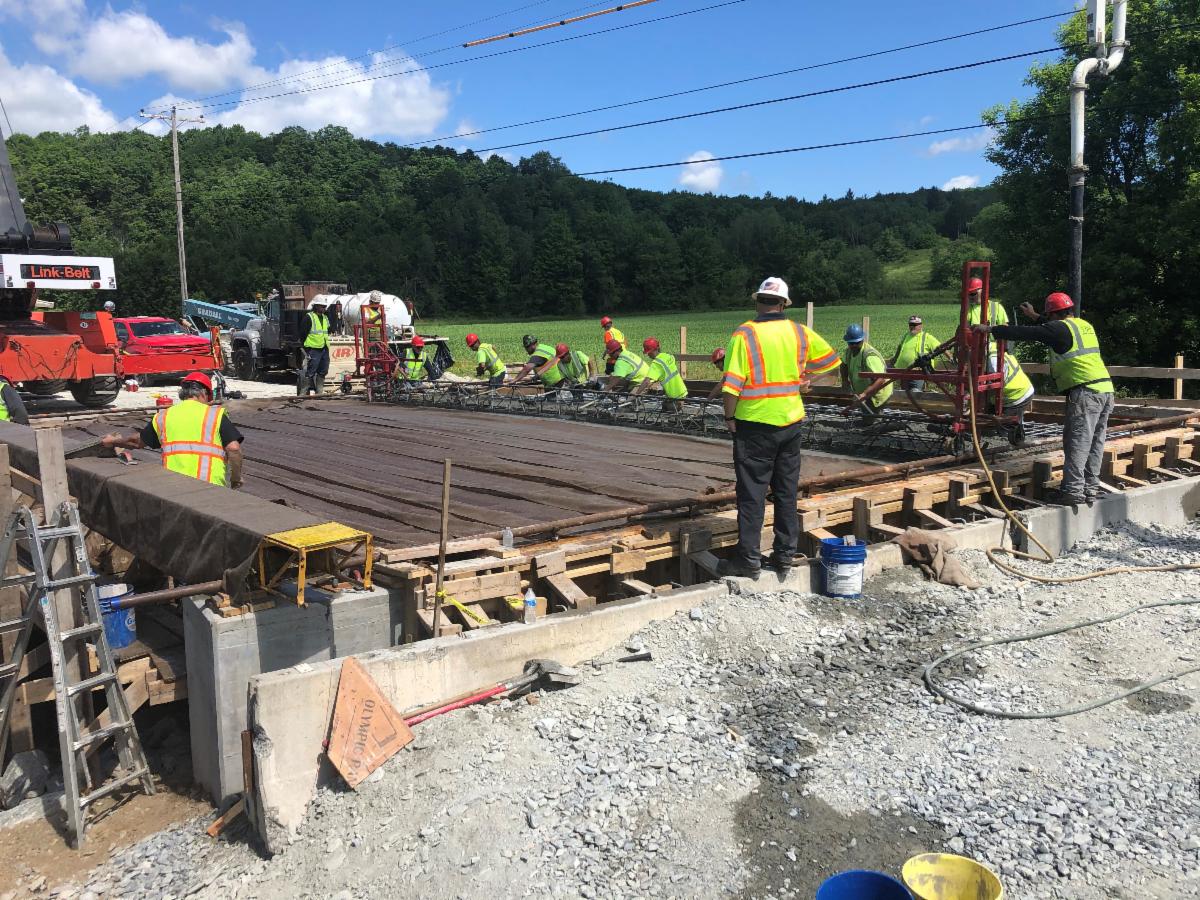

- Concrete pouring of the bridge deck and allow for curing time.
The following is the anticipated work schedule for the week beginning Monday, June 7, 2021:
- Construction continues on building the new bridge deck.
Bridge abutments stone filled

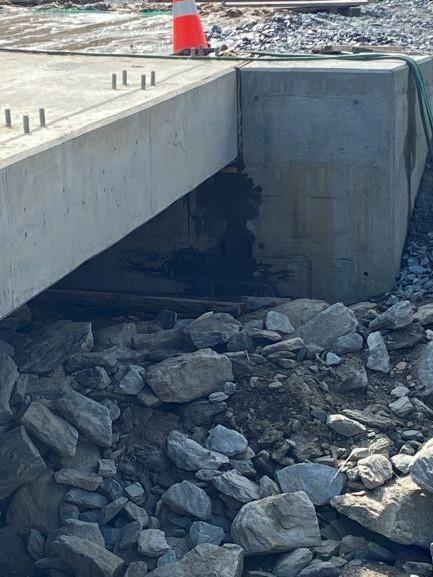

Both bridge abutments poured and cured, awaiting concrete deck; Erosion control still in place
The following is the anticipated work schedule for the week beginning Monday, May 31, 2021:
- No work due to the Memorial Day holiday
- Gravel placement for the bridge approaches

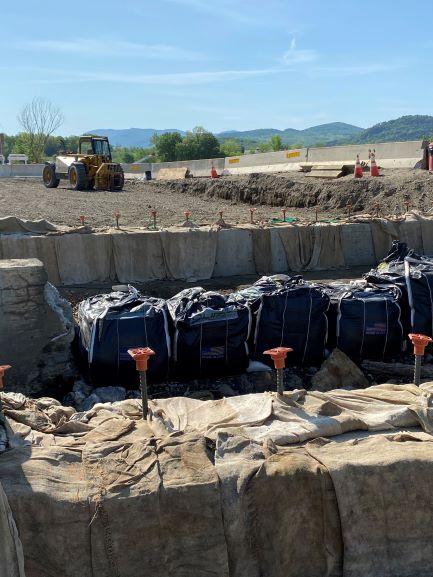

- Stone fill placement around the concrete at the bridge abutments
The following is the anticipated work schedule for the week beginning Monday, May 24, 2021:
- Prep work continues in anticipation of installation of concrete beams for the bridge deck
Poured concrete wall
Covering concrete to aid in the curing process

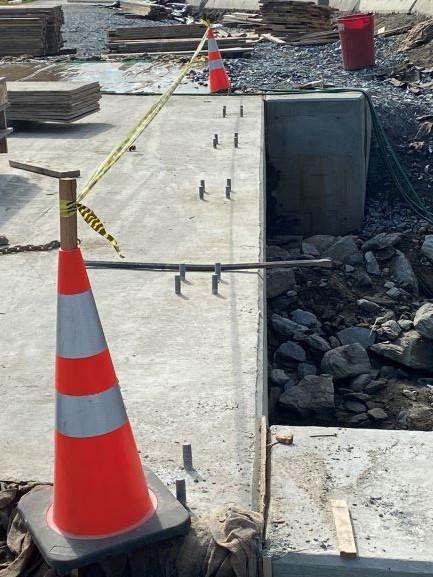

- Concrete footings will be poured, Friday May 14, 2021.
- Removal of forms installed to pour concrete footings
- Prep work begins for both bridge abutments
The following is the anticipated work schedule for the week beginning Monday, May 10, 2021:

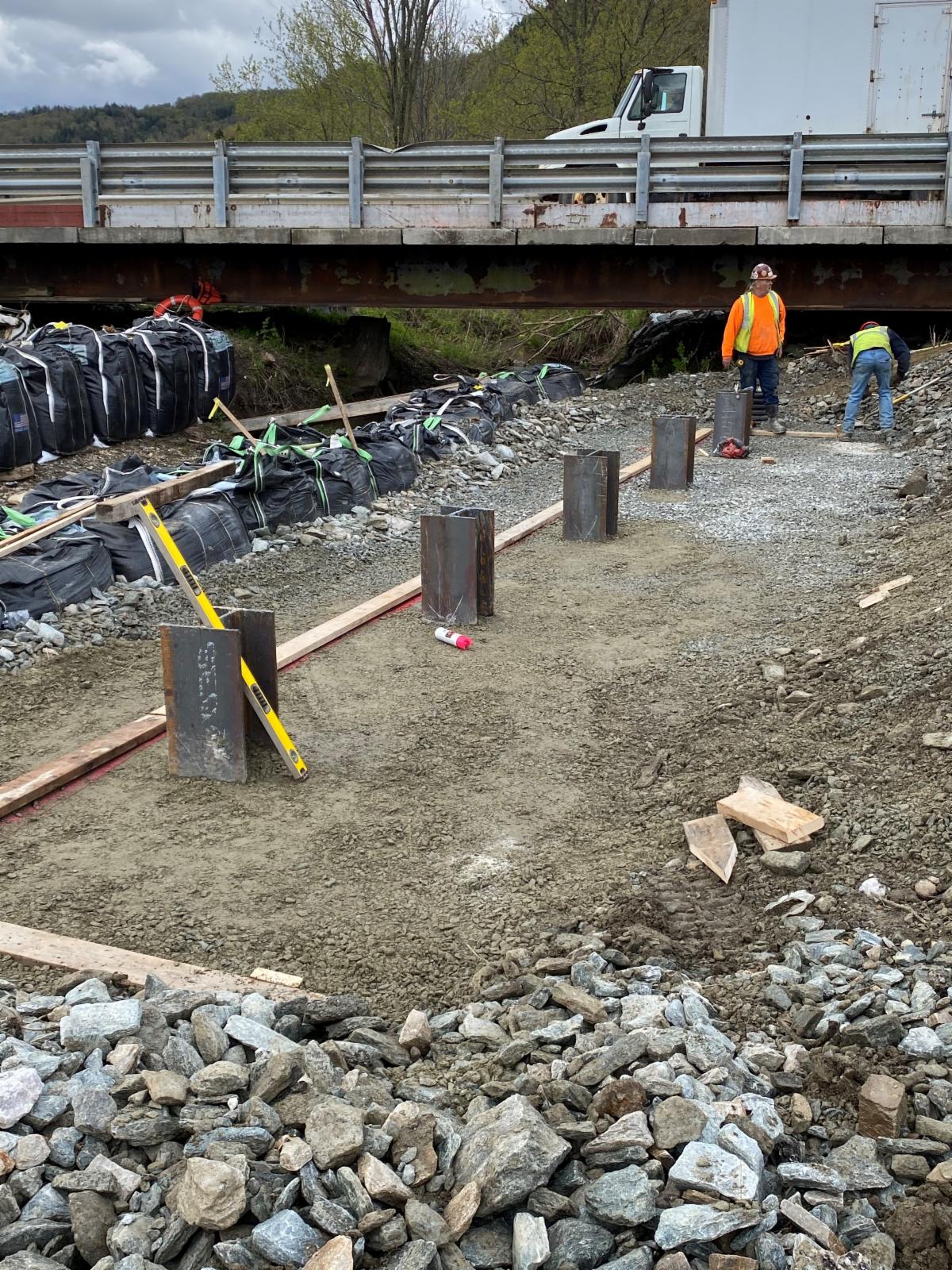

- Continue stabilization of the ground (driving pile) in preparation of building the new bridge abutments
The following is the anticipated work schedule for the week beginning Monday, May 3, 2021:

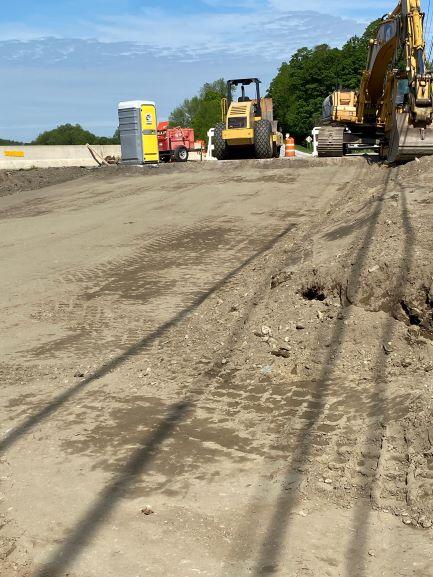

- Continue demolition of the old bridge. Motorists should be aware of truck traffic in/out of the work zone.
Today, April 27, 2021 motorists will be detoured onto the newly installed temporary bridge on VT Route 118. This detour is expected to open to all motorists at 3:00 p.m. and will remain in effect during the construction of the new bridge.
The following is the anticipated work schedule for the week beginning Monday, April 26, 2021:
- Continue building the approaches to the temporary bridge
- The temporary bridge is anticipated to open to motorists
- Begin demolition of the old bridge
Temporary bridge
The following is the anticipated work schedule for the week beginning Monday, April 19, 2021:
Monday through Friday:

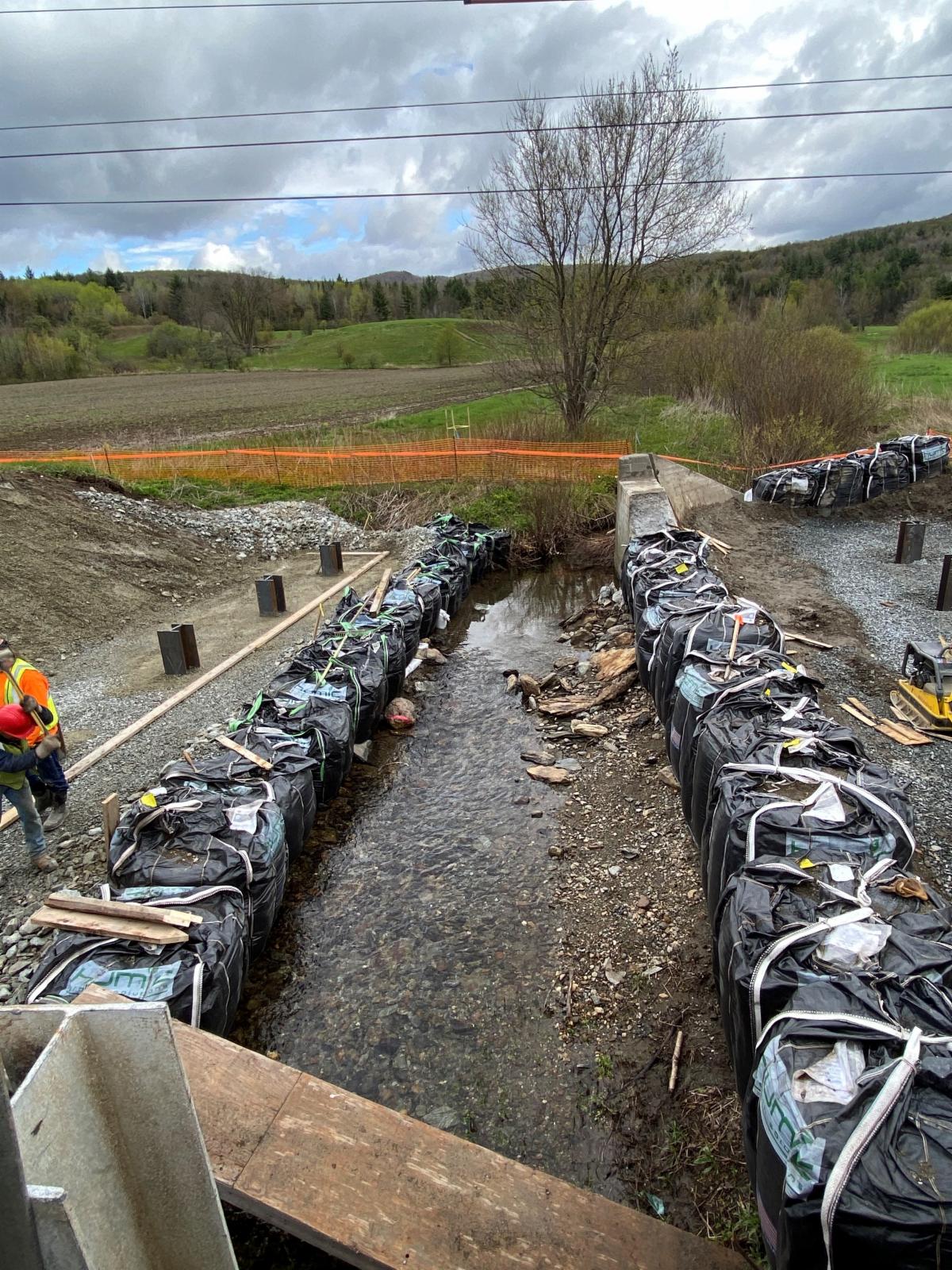

- Construction continues on the installation of the temporary bridge.
Motorists can expect a lane closure with traffic control to be present to assist in construction vehicles traveling in/out of the site locations.
