The Vermont Agency of Transportation in conjunction with Engineers Construction, Inc. (ECI) will begin the signal upgrade project the week of April 19, 2021 with the installation of construction signage. This project includes the replacement of the existing span wire signals with new mast arm poles at six intersections on U.S. Route 7, from McIntosh Avenue north to Swift Street. The six intersections include McIntosh Avenue, Baldwin Avenue, Laurel Hill Road, Brewer Parkway, Queen City Park Road and Swift Street.
This upgrade includes the installation of new mast arm poles, signals, cabinets and controllers, preemption systems, stop bars with advanced vehicle detection, pedestrian signals, and other related items. During construction, we anticipate minimal impact on the traveling public as the majority of the work will be done during nighttime hours. Traffic control will be present with lane closures during working hours. The anticipated completion is November 2021.
The following is the anticipated work schedule for the week beginning Monday, December 13 2021:
- General clean up work throughout the project.
The following is the anticipated work schedule for the week beginning Monday, December 6, 2021:
- General clean up work throughout the project.
- Traffic signal timing coordination work. Note this work will not have any traffic impact.
The following is the anticipated work schedule for the week beginning Monday, November 29, 2021:
Monday through Thursday - 7:00 p.m. to 6:00 a.m.
- Continue installation of signal equipment throughout the project.
The following is the anticipated work schedule for the week beginning tomorrow, November 19, 2021:
- Continue installation of signal equipment throughout the project.
- No work due to the Thanksgiving Day holiday
The following is the anticipated work schedule for the week beginning Monday, November 15, 2021:

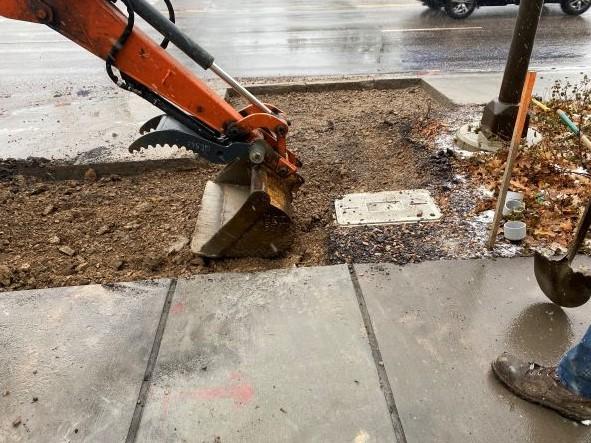

- Continue sidewalk restoration throughout the affected intersections within the project
- Continue installation of mast signal arms throughout the project
The following is the anticipated work schedule for the week beginning Monday, November 8, 2021:
- Continue sidewalk restoration throughout the affected intersections within the project
- Continue installation of mast signal arms throughout the project
- Continue sidewalk restoration throughout the affected intersections within the project
- Continue installation of mast signal arms throughout the project
The following is the anticipated work schedule for the week beginning Monday, October 25, 2021:
- Continue sidewalk restoration throughout the affected intersections within the project
- Continue installation of mast signal poles throughout the project
- Begin installation of mast signal arms throughout the project
The following is the anticipated work schedule for the week beginning Monday, October 18, 2021:

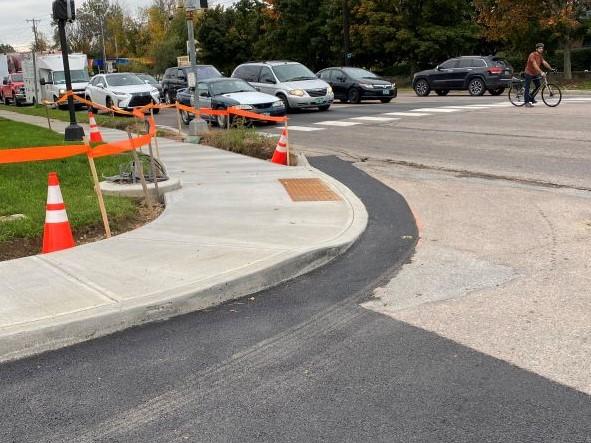

- Continue sidewalk restoration throughout the affected intersections within the project
- Begin installation of mast signal poles throughout the project
The following is the anticipated work schedule for the week beginning Monday, October 11, 2021:
- Continue site restoration to include setting sidewalks and curbing throughout the affected intersections within the project
- Weather permitting, patch paving between McIntosh Avenue and Brewer Parkway
The following is the anticipated work schedule for the week beginning Monday, October 4, 2021:
- Continue site restoration to include setting sidewalks and curbing throughout the affected intersections within the project
- Installation of mast signal poles throughout the project
The following is the anticipated work schedule for the week beginning Monday, September 27, 2021:
- Continue site restoration to include setting sidewalks and curbing throughout the affected intersections within the project
- Installation of pedestrian crosswalk signal poles
The following is the anticipated work schedule for the week beginning Monday, September 20, 2021:

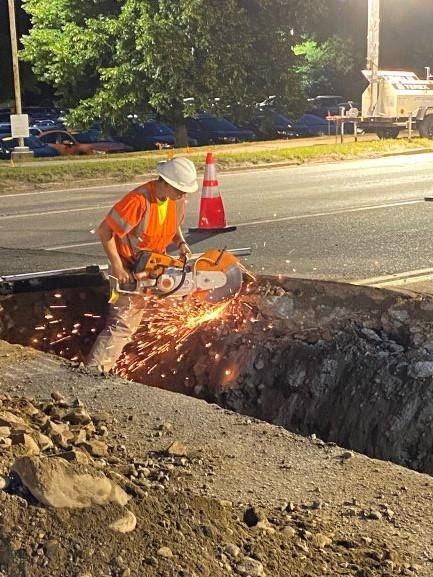

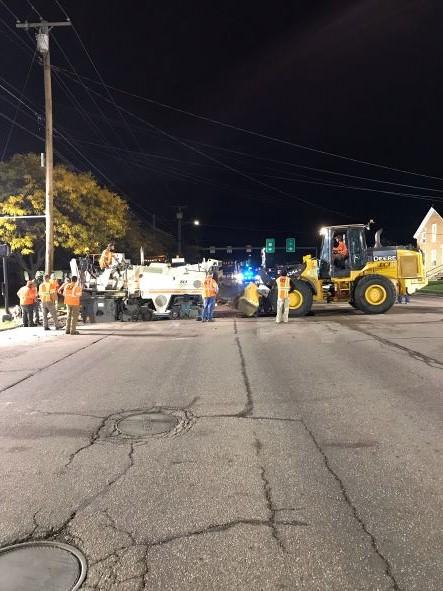

- Milling (grinding the existing pavement) the crossings within the project to prep for final paving

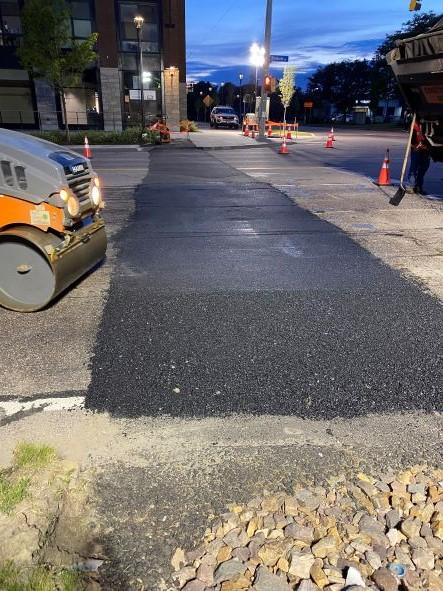

- Weather permitting, paving the milled crossings
- Continue site restoration to include repairing the sidewalks and curbing
The following is the anticipated work schedule for the week beginning Monday, September 13, 2021:
- Continue pulling wire within the intersections throughout the project.
The following is the anticipated work schedule for the week beginning Monday, September 6, 2021:
- No work due to the Labor Day holiday
- Restoration of project site to include repairing sidewalks
This project is on hold until September 7, 2021 when it is anticipated to have received the signal equipment to be installed.
The following is the anticipated work schedule for the week beginning Monday, August 16, 2021:
- Continue installation of the junction boxes, traffic control cabinet foundations and pedestian signals
- General project clean up
Motorists should expect traffic control present with lane closures within the work areas.
The following is the anticipated work schedule for the week beginning Monday, August 9, 2021:
- Continue installation of the junction boxes, traffic control cabinet foundations and pedestian signals
- General project clean up
Motorists should expect traffic control present with lane closures within the work areas.
The following is the anticipated work schedule for the week beginning Monday, July 26, 2021:
- Begin installation of the junction boxes, traffic control cabinet foundations and pedestian signals
- General project clean up
Motorists should expect traffic control present with lane closures within the work areas.
The following is the anticipated work schedule for the week beginning Monday, July 26, 2021:
- Begin installation of the junction boxes, traffic control cabinet foundations and pedestian signals
- General project clean up
Motorists should expect traffic control present with lane closures within the work areas.
The following is the anticipated work schedule for the week beginning Monday, July 19, 2021:
- Begin installation of the junction boxes and traffic control cabinet foundations
- General project clean up
Motorists should expect traffic control present with lane closures within the work areas.
The following is the anticipated work schedule for the week beginning Monday, July 12, 2021:

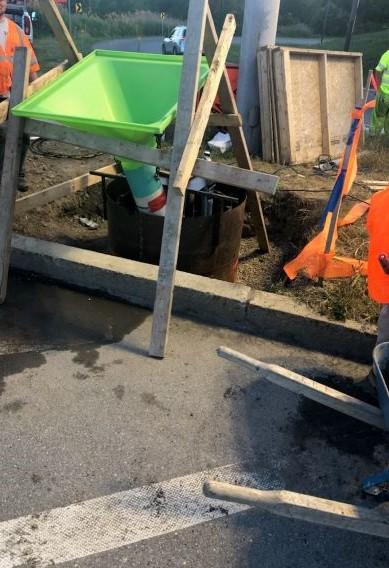

- Continue pouring concrete for the mast pole foundations throughout the project limits
- General cleanup throughout the project
The following is the anticipated work schedule for the week beginning Monday, July 5, 2021:
- No work due to the Independence Day holiday
- Continue pouring concrete for the mast pole foundations throughout the project limits.
Motorists should expect traffic control present with lane closures within the work areas.
Motorists should expect delays between 7:00 p.m. to 10:00 p.m. as traffic will be reduced to one lane of travel in each direction, north and south.

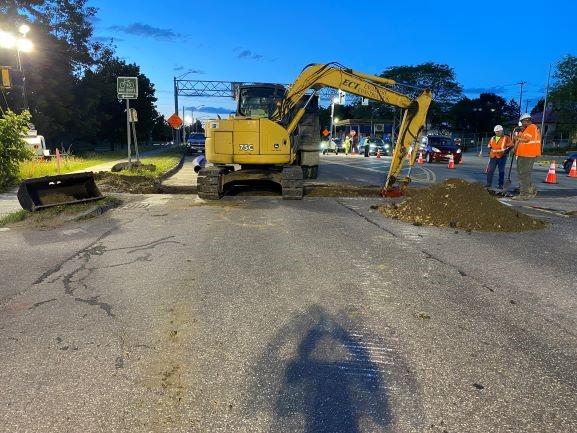

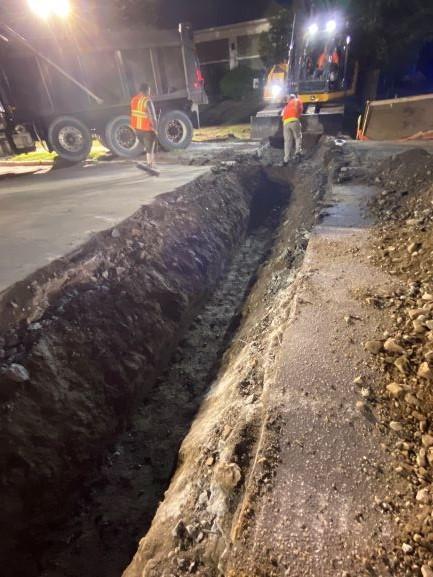

- Continue installation of electrical conduit piping "sleeves" across Route 7 throughout the project intersection locations. During these operations, traffic will be reduced to one lane of travel in each direction, north and south.
Excavating down to connect electrical conduit piping
Electrical piping to be connected
The following is the anticipated work schedule for the week beginning Monday, June 21, 2021:
- Begin installation of electrical conduit piping "sleeves" across Route 7 throughout the project intersection locations. During these operations, traffic will be reduced to one lane of travel in each direction, north and south.
- Continue installation of mast pole foundation sleeves throughout the project locations.


The following is the anticipated work schedule for the week beginning Monday, June 14, 2021:
- Continue installation of mast pole foundation sleeves throughout the project locations.
- Begin installation of electrical conduit piping "sleeves" across Route 7 throughout the project intersection locations. During these operations, traffic will be reduced to one lane of travel in each direction, north and south.

The following is the anticipated work schedule for the week beginning Monday, June 7, 2021:
- Continue installation of electrical conduit piping "sleeves" throughout the project intersection locations.
- Continue installation of mast pole foundation sleeves throughout the project locations.

The following is the anticipated work schedule for the week beginning Monday, May 31, 2021:
- No work due to the Memorial Day holiday
- Continue installation of electrical conduit piping "sleeves" throughout the project intersection locations.
- Continue installation of mast pole foundation sleeves throughout the project locations.

The following is the anticipated work schedule for the week beginning Monday, May 24, 2021:
- Continue installation of electrical conduit piping "sleeves" throughout the project intersection locations.

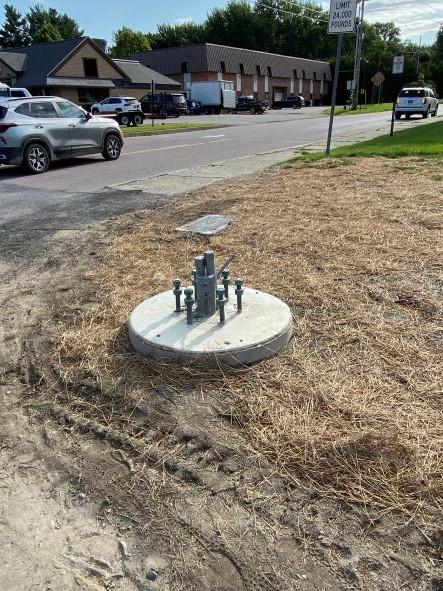

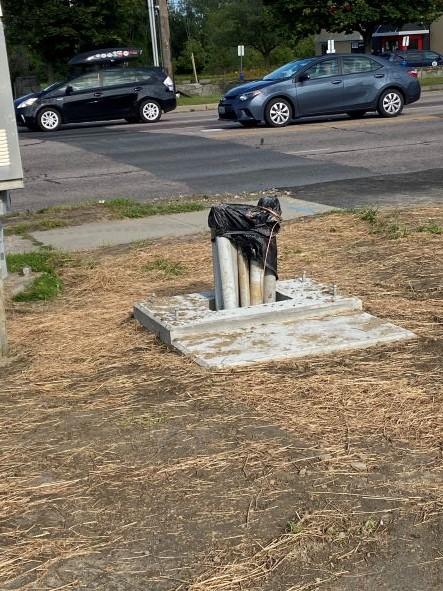

- Begin installation of mast pole foundation sleeves throughout the project locations.


The following is the anticipated work schedule for the week beginning Monday, May 17, 2021:
- Continue installation of electrical conduit piping "sleeves" throughout the project intersection locations.

The following is the anticipated work schedule for the week beginning Monday, May 10, 2021:
- Directional underground drilling at the intersections of Baldwin Avenue, Laurel Hill Road and Brewer Parkway to install piping "sleeves" for electrical wires.


The following is the anticipated work schedule for the week beginning Monday, May 3, 2021:
- Directional underground drilling at the intersection of Swift Street to install piping "sleeves" for electrical wires.
- If time allows, Wednesday or Thursday directional underground drilling at the intersection of Queen City Park Road.
The following is the anticipated work schedule for the week beginning Monday, April 26, 2021 throughout the six locations:
- Work begins with contractor mobilization
- Location of underground utilities
The following is the anticipated work schedule for the week beginning Monday, April 19, 2021:
Monday through Friday:
- Installation of construction signs.
There should be little to no effect to the traveling public.
